Keating ChambersConstruction, Interrupted

The seminar

Construction, Interrupted: the 90-minute seminar on delay and disruption from which this guide grew. The slides run in the browser and need no connection.

  1. Opening Two questions 2 min
  2. 01 Time and money 11 min
  3. 02 Proving delay 18 min
  4. 03 Concurrency 8 min
  5. 04 Disruption 15 min
  6. 05 The money 11 min
  7. 06 Before the tribunal 4 min
  8. Close Ten points to take away 4 min

Open the slides

The critical path
Play
The model project is built in 3D, then unstacks into a programme. The critical path lights up, float appears, and a late roof design pushes completion past the contract date (70 seconds).
Prospective and retrospective
Play
At week 12 the future opens as a fan of possible outcomes and one forecast is drawn from it. At completion the as-built record is traced back and its critical path lights up (40 seconds).
Six methods, one project
Play
Each of the six SCL Protocol methods runs over the same records and puts a figure on the employer's share of nine weeks of delay. The six answers land side by side (68 seconds).
Earned value
Play

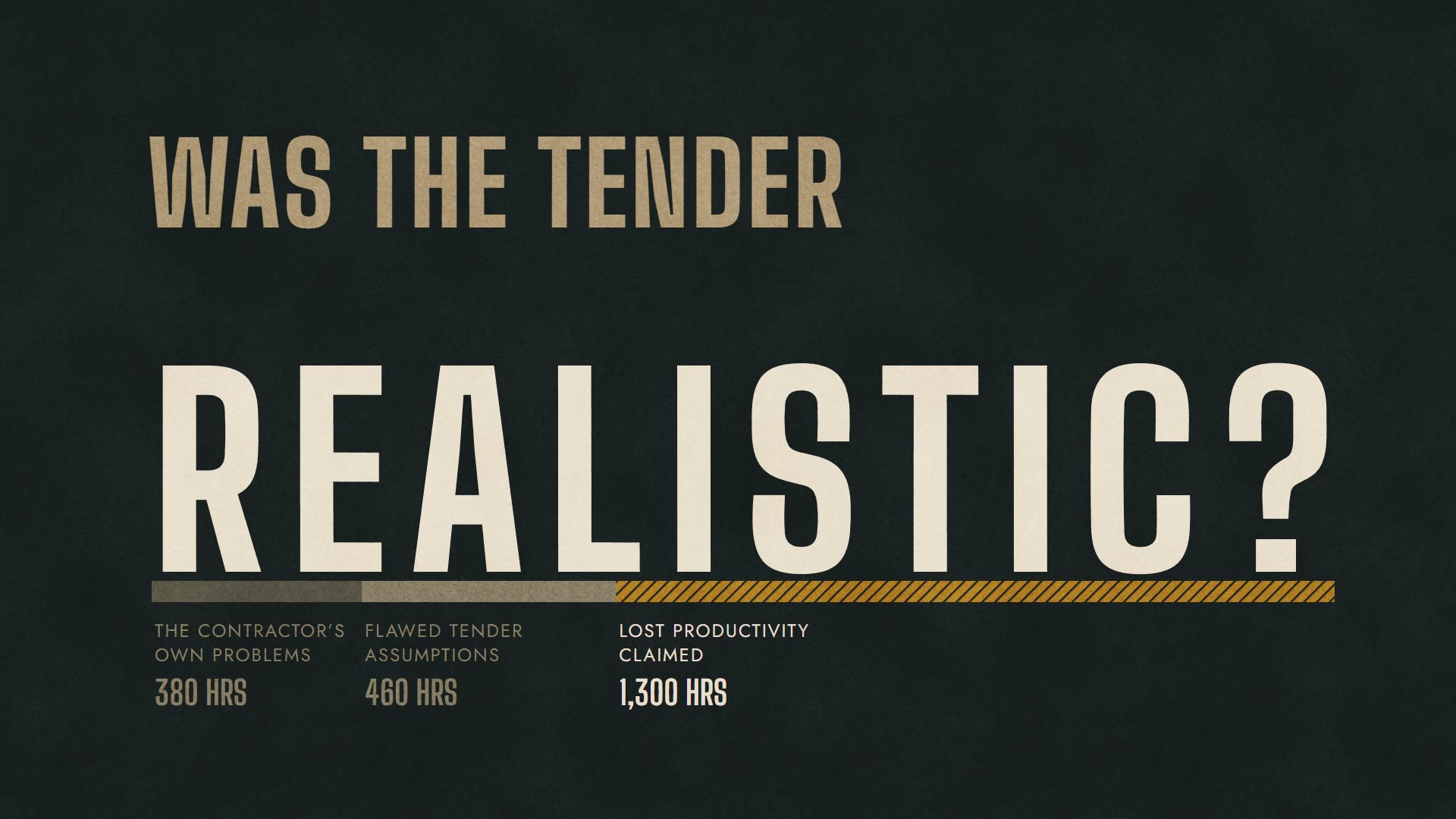

Hours per unit times quantity gives the planned hours, and the hours spent run past them. The contractor's own problems and flawed tender assumptions come out before the rest is claimed (30 seconds).
The measured mile

Play
A settled run sets the rate, which is carried across the disrupted weeks: the gap is the loss, in productivity and in hours. Picking the best weeks is shown as a mistake (35 seconds).
